Solar Panel Installation for Flat Roofs Installing solar panels on a flat roof is not a weekend DIY project. It combines structural assessment, weatherproofing, wind-resistance engineering, solar positioning, electrical work, and strict code compliance into one coordinated job.

Depending on your property and system design, you may need a qualified solar installer, a roofing professional, a structural engineer, and a licensed electrician — sometimes all four. Skipping any of these steps carries real risk.

Get it wrong, and you could face low energy output, row-to-row shading, a punctured roof membrane, water intrusion, wind-related panel movement, electrical hazards, or denied permits and voided warranties. This guide walks through the full installation process, from roof assessment to system commissioning, so you know exactly what a professional job should include.

Key Takeaways

  • Most flat roofs can support solar, but panels need tilting, spacing, and securing around drainage, wind, and structural limits
  • A structural and roof-condition assessment must happen before you choose equipment
  • Mounting options fall into two camps: non-penetrating ballasted systems or mechanically attached systems
  • Electrical testing, waterproofing checks, and permit approval must happen before the system runs normally

Prerequisites and Safety Considerations

Before anyone sets foot on your roof with racking equipment, a handful of checks need to happen first.

What Needs Assessment First

A qualified installer or engineer should evaluate:

  • Roof condition: age, membrane health, drainage paths, parapets, skylights, HVAC units, vents, and any existing leaks or ponding water
  • Structural capacity: whether the roof deck can handle panels, racking, ballast weight, wind uplift forces, and snow loads where applicable
  • Site conditions: sun exposure, nearby trees or buildings, row-to-row shading risk, usable roof area, and the available electrical service capacity

This isn't a job for a tape measure and a flashlight. The IBC's structural chapter requires full module and ballast dead load, concentrated support-frame loads, and ponding checks for roofs carrying ballasted PV systems. A visual inspection alone won't confirm any of this. You need an engineer's sign-off.

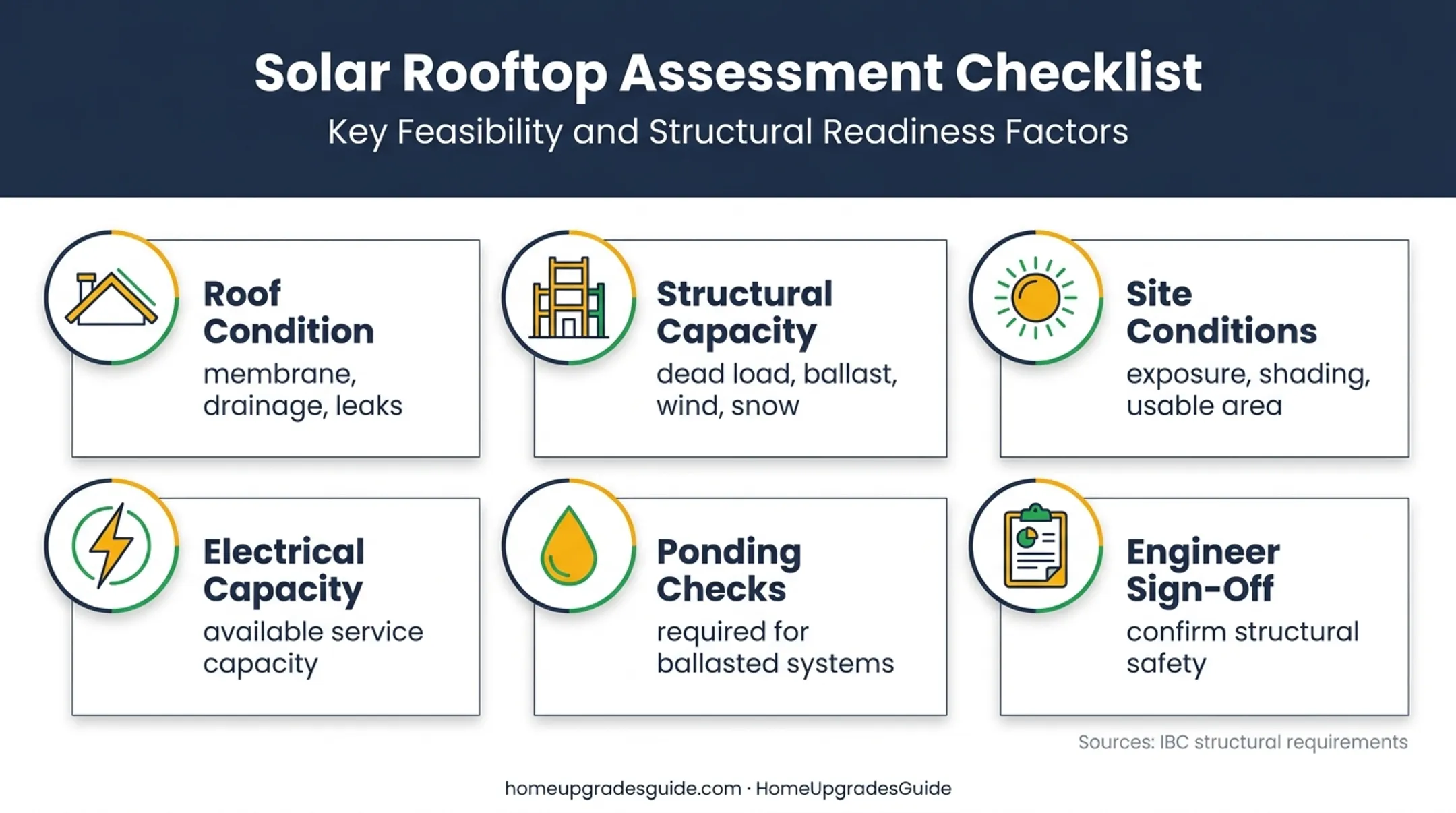

Flat roof solar structural assessment requirements and design checks

Non-Negotiables Before Work Begins

Do not move forward if any of the following apply:

  1. The roof needs major repair or replacement within the next few years
  2. There are unresolved leaks or blocked drainage
  3. Load capacity hasn't been verified by a qualified professional
  4. Roof access is unsafe for workers
  5. The installation plan doesn't meet local code or utility interconnection requirements

Permitting, utility interconnection, fire-access pathways, equipment setbacks, and any HOA or building-management approvals all need confirmation before installation starts.

Wind design deserves particular attention. ASCE's standard includes a section specifically addressing rooftop solar panels on flat roofs, because wind behaves differently around a low-profile array than it does around a traditional roof surface. That section is a required design check for flat-roof arrays, not an optional extra.

Rooftop work also means fall risk. OSHA requires fall protection for installers exposed to drops of six feet or more, using guardrails, safety nets, or personal fall-arrest systems. Lifting panels, cutting penetrations, and making electrical connections should be handled by professionals using proper lockout and de-energization procedures — not a homeowner with a ladder.

Tools and Parts Required

Flat-roof solar systems involve more specialized hardware than a typical pitched-roof install. Here's what's generally involved, split by category.

Mounting and structural components:

  • Solar panels, racking or tilt frames, and mounting clamps
  • Roof-protection pads to prevent membrane wear
  • Ballast blocks or approved mechanical roof attachments
  • Flashing and sealing materials (for penetrating systems)
  • Bonding and grounding hardware

Electrical components:

  • Inverter, disconnects, and rapid-shutdown equipment where required
  • Electrical conduit, conductors, and monitoring hardware
  • Labels and connection equipment per code

Survey and safety equipment:

  • Layout tools, lifting equipment, and fall-protection gear
  • Testing meters (insulation resistance, continuity, voltage)
  • Manufacturer-specific installation tools

Ballast blocks, anchors, fasteners, and sealants must be engineered or approved for your specific roof assembly. Swapping in improvised substitutes (generic concrete blocks instead of specified ballast, for instance) can void warranties or compromise system stability in high winds.

The installer should follow panel, racking, and structural-engineering documentation, not a generic parts list from a forum.

How to Install Solar Panels on a Flat Roof (Step-by-Step)

Flat-roof solar isn't simply a matter of setting panels down and connecting wires. The process runs in sequence: assessment and design → permitting and prep → mounting and panel placement → electrical integration → inspection and commissioning.

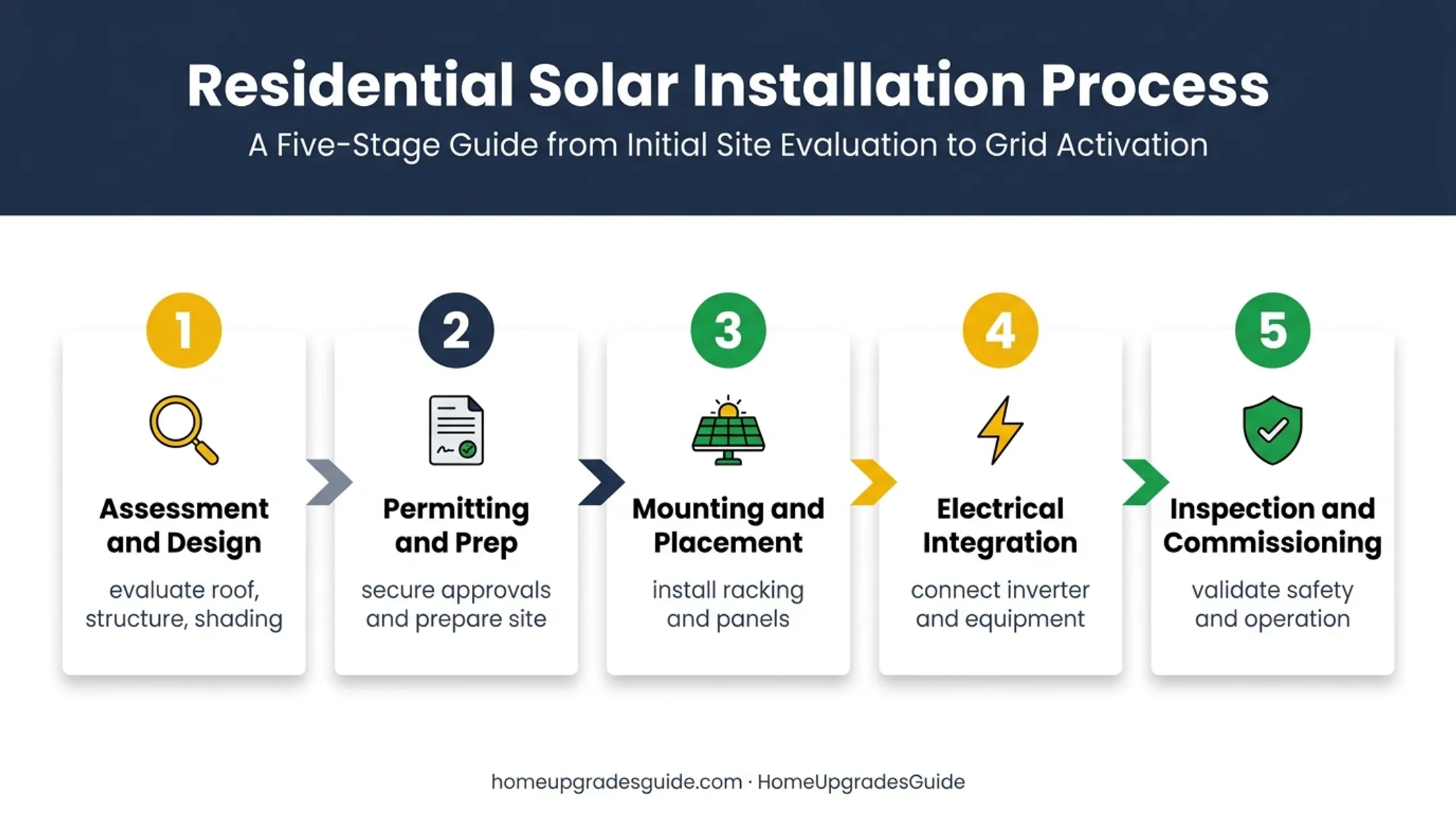

Five-stage flat roof solar installation process from design to commissioning

Even though a flat roof often provides easier physical access than a steep-pitched one, the design and safety requirements are no less demanding. Your final layout depends on the roof's usable area, existing obstructions, local climate, shading conditions, your household's electricity needs, and applicable building, electrical, fire, and utility codes.

Preparing the Installation Site

Before any hardware goes up, the crew should:

  • Complete the roof and structural survey, documenting obstructions and drainage routes
  • Confirm the approved layout matches the engineered design
  • Repair or replace the roof first if its remaining service life is too short to outlast the solar system

Setbacks, maintenance paths, fire-access routes, inverter and disconnect locations, panel rows, and cable pathways should all be marked out according to the approved plan. During staging, the crew needs to protect the roof membrane from foot traffic and material drops, and keep tools and packaging away from drains and fragile roof sections.

Positioning and Securing the Mounting System

This is where ballasted and mechanically attached systems diverge:

  • Ballasted systems avoid roof penetrations entirely but add substantial dead weight to the roof structure
  • Mechanically attached systems require carefully sealed penetrations but generally need less overall mass

Either way, the installer sets the planned tilt and orientation, maintains spacing to limit self-shading between rows, and keeps the array clear of roof edges, parapets, drains, vents, skylights, and access routes.

Installers distribute ballast or fasteners according to the engineered wind-load plan, with extra attention at roof corners and edges where wind uplift forces concentrate. Racking should end up level, stable, and properly bonded or grounded before a single panel goes on.

Installing Panels and Integrating the Electrical System

Each panel is secured with the manufacturer's specified clamps and torque settings. Crews shouldn't walk on panel surfaces, and clearances need to stay open for ventilation, wiring access, and future maintenance.

Conductors must be routed and secured so they're protected from abrasion, standing water, sharp edges, and unsupported spans. Cable runs shouldn't block drainage paths; that's a common oversight that creates problems later.

From there, the array connects to the inverter, disconnects, rapid-shutdown equipment, electrical panel, monitoring system, and utility interconnection equipment per the approved design. The NEC's rapid-shutdown rule sets a 1-foot array boundary; conductors outside that boundary must drop to 30 volts within 30 seconds of shutdown initiation.

A licensed electrician should verify polarity, voltage, grounding, and overcurrent protection before anything gets energized. Before wrapping up, the installer documents panel layout, serial numbers, equipment settings, ballast calculations, photographs, and warranty paperwork for you to keep.

Post-Installation Checks and Validation

Mounting the panels does not complete the job. Commissioning, the final validation stage, confirms the system is safe and ready to operate.

Visual and Structural Checks

The crew should confirm:

  • Panels and racking are secure, with clamps and fasteners meeting specified torque
  • Ballast or anchors match the approved engineering plan
  • No roof membrane, flashing, curb, drain, or parapet was damaged during installation
  • Walkways, fire-access paths, cable supports, and drainage routes remain unobstructed
  • The array has the intended tilt, orientation, row spacing, and shading clearance

Electrical and Functional Testing

Before the system goes live, testing should cover:

  1. Polarity and continuity across all circuits
  2. Insulation resistance and grounding/bonding verification
  3. String voltage and inverter operation checks
  4. Rapid-shutdown function testing
  5. Monitoring communications to confirm production data is reporting correctly

Required inspections, utility approval, and permission to operate all need to be finalized before normal use begins. The DOE's permitting guidance describes this as a sequence: local inspection for code compliance happens first, followed by separate utility interconnection approval. These are two different milestones, not one.

At handoff, you should receive:

  • Operating manual and warranty documents
  • Maintenance guidance and emergency shutdown instructions
  • As-built drawings and service contact information

Most monitoring platforms let you compare actual production against a modeled estimate, often from tools like PVWatts that factor in location, tilt, and system size. No single benchmark fits every home. A consistent, unexplained gap between modeled and actual production over a few months is worth raising with your installer.

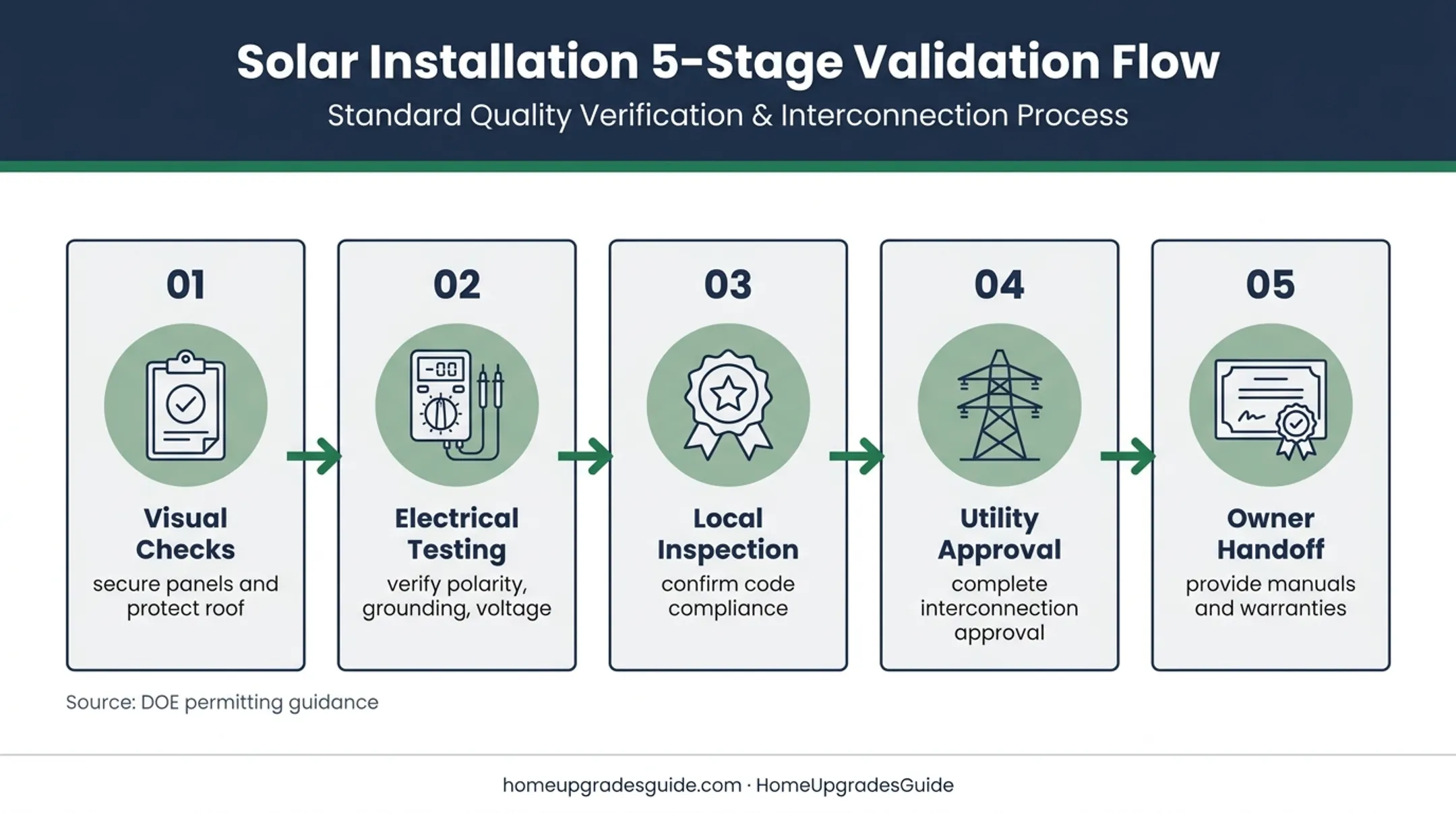

Solar system validation sequence from visual checks to owner handoff

Common Installation Problems and Fixes

Even well-designed systems can run into issues. Here's how to recognize and respond to the most common ones.

Roof leaks or membrane damage

  • Problem: Water intrusion or new ponding appears after installation
  • Likely cause: Damaged roof materials, blocked drainage, poorly detailed penetrations, or incompatible roof-contact materials
  • Fix: Stop further damage, document the area, and have a qualified roofer work with your installer to repair the roof or attachment before restoring the system

Row shading or lower-than-expected production

  • Problem: The array underperforms its projection, or certain rows see regular shade
  • Likely cause: Incorrect tilt, insufficient row spacing, new nearby obstructions, or inaccurate design assumptions
  • Fix: Compare monitoring data against the original design, check for shading or soiling, and have the installer adjust layout or electrical configuration as needed

Movement, wind damage, or electrical faults

  • Problem: Panels or racking shift, cables loosen, or the inverter throws fault codes
  • Likely cause: Insufficient ballast or anchoring, improper fastening, weather exposure, or a commissioning error
  • Fix: Keep people clear of the area, de-energize the system if it's safe to do so, and call the installer or a licensed electrician for inspection. Do not attempt rooftop repairs yourself

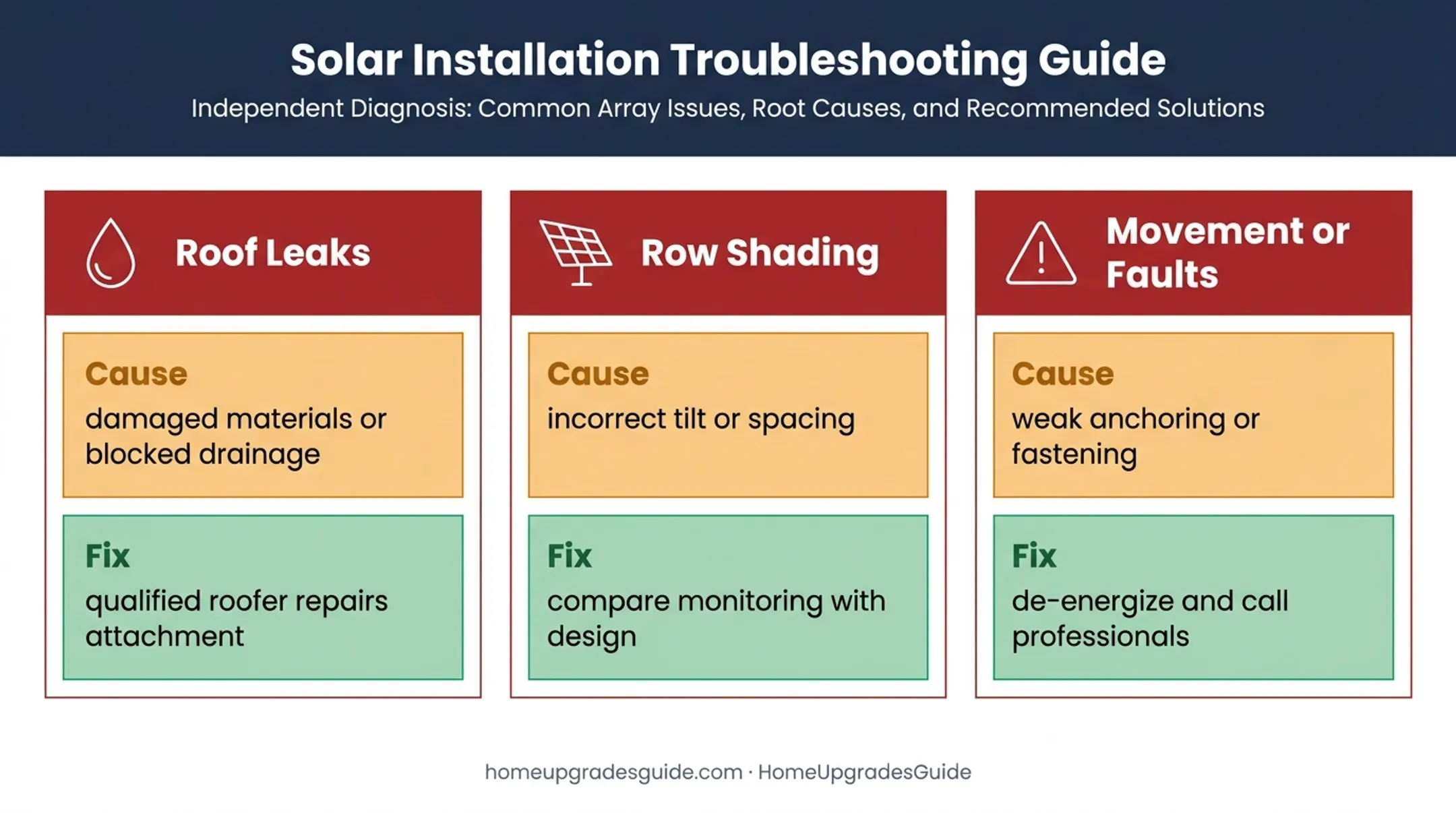

Three common flat roof solar problems causes and recommended fixes

Pro Tips for Installing Solar Panels Effectively

A few practical habits separate a smooth installation from a stressful one.

  • Schedule your roof inspection before finalizing solar proposals. Replacing or repairing a roof after solar goes up often means temporary panel removal and extra labor costs you could've avoided.
  • Ask every installer the same hard questions: How does your proposal address roof load, wind uplift, drainage, shading, row spacing, fire access, attachment method, roof warranties, and permitting?
  • Compare proposals on substance, not just price. Look at equipment compatibility, workmanship coverage, production assumptions, and contract terms, not simply panel count or the lowest bid.
  • Request a site-specific layout. The right tilt, orientation, and panel count depend on your particular roof. A generic quote without a production model showing why that layout fits your home is a red flag.

If you'd rather skip the cold-calling and start by comparing options, HomeUpgradesGuide lets you request free solar quotes and review matches from vetted local contractors. You decide who to talk to and when, with no obligation attached.

Conclusion

Flat-roof solar can be a strong option when the roof, structure, mounting method, panel layout, and electrical system are evaluated as one connected system rather than separate decisions.

Preparation, weatherproofing, wind resistance, code compliance, and post-installation testing all shape your system's safety, output, roof longevity, and warranty coverage.

Before committing to any contractor, get detailed proposals from qualified local professionals and compare their design and installation plans side by side. HomeUpgradesGuide helps you request free quotes from vetted local solar installers and compare options on your schedule.

Frequently Asked Questions

Can solar panels be installed on a flat roof?

Yes. Most flat roofs can support solar once the structure, roof condition, mounting system, tilt, drainage, shading, and wind loads have been properly evaluated by a qualified professional.

What are the pros and cons of installing solar panels on a flat roof?

Flat roofs offer flexible panel orientation and easier physical access for installation and maintenance. The tradeoff includes added racking, ballast or attachment requirements, mandatory row spacing, and more involved structural review.

Is it possible to mount solar panels on a flat roof without drilling?

Yes, through non-penetrating ballasted systems that rely on weight rather than fasteners. The tradeoff is added roof load, so mechanical attachments may suit roofs with stricter structural limits or high wind exposure better.

How many solar panels can I fit on a flat roof?

It depends on your usable roof dimensions, panel size, tilt angle, required row spacing, setbacks, obstructions, access paths, structural limits, and your household's electricity needs. There's no fixed per-square-foot formula.

What is the best angle to mount solar panels on a flat roof?

There's no single ideal angle for every location in the US. A qualified installer should model tilt and orientation against seasonal sunlight, self-shading, wind exposure, ballast requirements, and your available roof area.

How high can solar panels be on a flat roof?

Height depends on the racking design, chosen tilt, parapet conditions, local zoning or building requirements, fire-access rules, wind loading, and any permit limitations specific to your municipality.
