Get any piece wrong, and the consequences range from reduced backup performance to a failed inspection or a genuine fire hazard. A qualified solar-storage installer or licensed electrician needs to assess, install, commission, and inspect the system. Homeowners can plan and ask good questions, but opening energized equipment isn't a DIY task.
This guide walks through the full process: assessing your home, confirming compatibility, preparing the site, connecting the battery, commissioning the controls, and verifying everything works before you ever need it during an outage.
Key Takeaways
- Professional installation is required because batteries connect directly to your electrical panel, inverter, and utility grid
- Confirm compatibility, space, electrical capacity, permits, and backup goals before equipment arrives
- Installation includes assessment, placement, wiring, configuration, inspection, and homeowner training
- Battery capacity alone doesn't guarantee whole-home backup; power output and critical-load selection matter just as much
- Compare itemized quotes covering equipment, labor, permits, upgrades, warranties, and monitoring
Installation Guide for Home Solar Batteries
A solar battery installation follows a coordinated sequence: evaluate your home and existing solar setup, design the storage system, pull permits, mount the equipment, wire it into the appropriate inverter or gateway, configure the operating modes, and validate performance before handoff.
Timeline and complexity vary based on a few key factors:
- Whether you're adding a battery to an existing solar system or installing both together
- Distance between the battery location and your main electrical panel
- Your panel's available capacity
- Local permitting requirements
- The backup design you choose (partial-home versus whole-home)
Prerequisites and Safety Considerations
Before anyone touches a wrench, define your primary goal. Are you after outage backup, better solar self-consumption, time-of-use bill management, or full off-grid independence? This decision shapes every equipment choice that follows.
Next, your installer needs to assess site readiness:
- A wall or floor location that meets manufacturer clearance requirements
- Protection from flooding, physical impact, and extreme temperatures
- Adequate ventilation
- Accessible space for future service work
- Safe routing options for conduit and wiring
Compatibility checks matter just as much as physical space. Your installer should verify the battery, inverter, existing solar panels, electrical panel, and monitoring platform all work together, plus confirm utility interconnection requirements.
Clearance requirements aren't universal across brands. Tesla's Powerwall 3 documentation calls for 4 inches of side clearance, 2 inches above, and 36 inches of front working space under NEC 110.26. Enphase's IQ Battery 5P requires at least 3 inches between units when mounted at the same level.
The applicable fire code and NFPA 855 standard govern separation and installation requirements, and your installer must follow whichever edition your local authority has adopted.
Finally, review your electrical capacity. Service size, panel condition, available breaker space, and starting loads from motors or pumps all factor into whether you need a critical-loads panel or a service upgrade.
Stop work immediately if equipment arrives damaged, permits aren't in hand, wiring is energized during installation, or proposed components aren't manufacturer-approved for compatibility.
Tools and Parts Required
A typical battery installation includes:
- Battery cabinet or module
- Mounting hardware
- Inverter or hybrid inverter (where required)
- Gateway or transfer equipment
- Disconnects and overcurrent protection
- Conduit, conductors, grounding, and bonding hardware
- Communications equipment and monitoring accessories
Some items ship with the battery package. Others depend entirely on your project, such as a backup-loads panel, additional breakers, trenching, or a full panel upgrade.
Professional installers also rely on electrical testing instruments, torque tools, lifting equipment, and manufacturer-specific commissioning software. Generac's installation manual, for example, directs installers to verify torque specs and perform tug tests on every connection. This isn't equipment you'll find in a typical homeowner's garage, and that's by design.

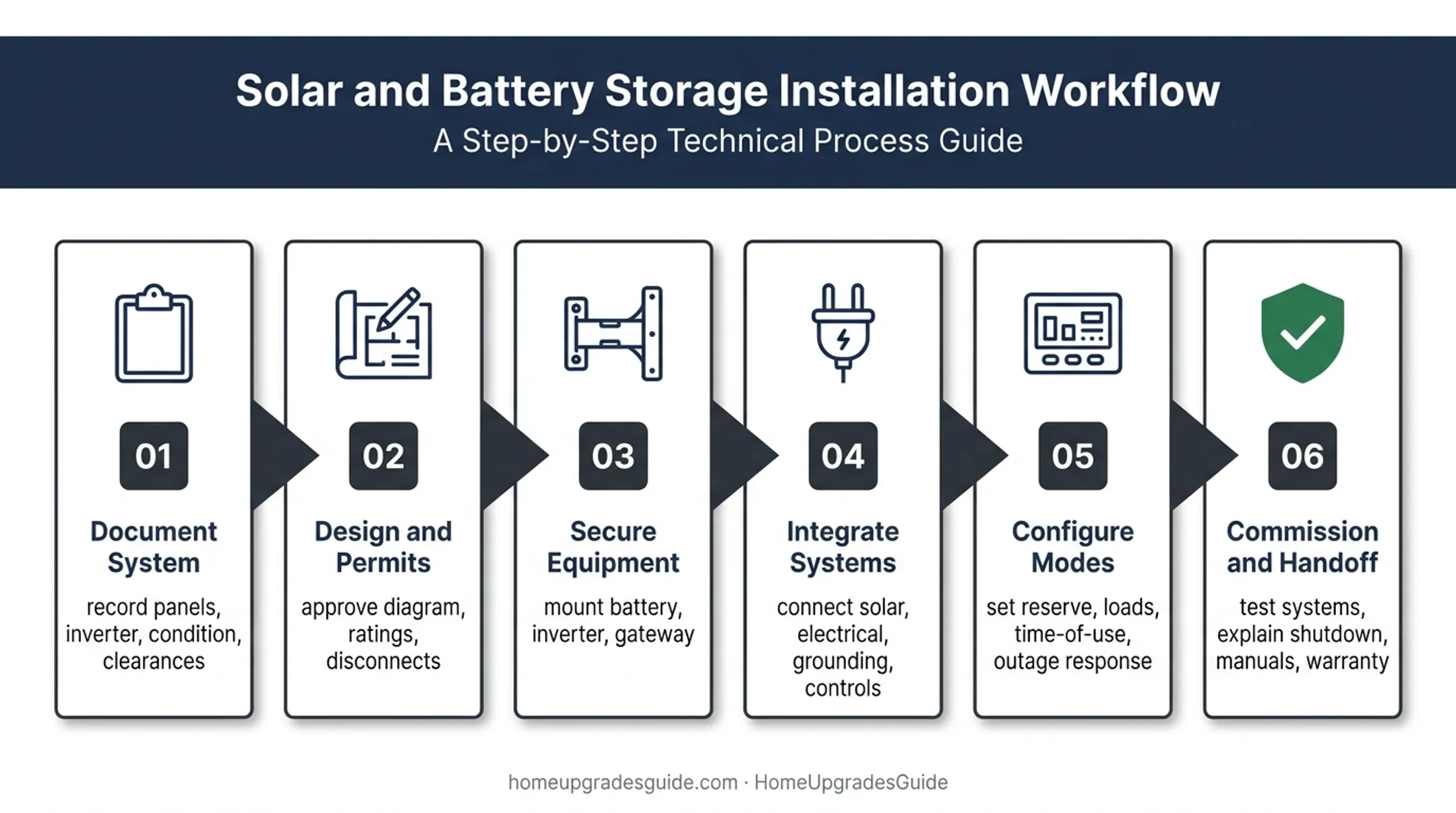

How to Install Home Solar Batteries Step-by-Step
The steps below give homeowners a high-level view of the process. They are not instructions for performing electrical work yourself. Your installer must follow the manufacturer's instructions, approved plans, local codes, and utility requirements at every stage.
- Document the existing system. The installer records panel and inverter information, checks electrical equipment condition, confirms mounting surfaces and clearances, and identifies cable routes.
- Complete design, permitting, and utility steps. This happens before anything gets energized. The approved one-line diagram, equipment ratings, and emergency disconnect locations all need sign-off first.
- Position and secure equipment. The battery, inverter, and gateway get mounted according to the approved design, with full attention to clearances, weight support, weather protection, and labeling.
- Integrate with your electrical and solar systems. This step uses the appropriate AC-coupled or DC-coupled configuration, complete with disconnects, grounding, communications, and backup-islanding controls.
- Configure operating modes. Reserve state of charge, critical-load selection, time-of-use settings, and outage response all get programmed to match your goals and utility rules.
- Commission and hand off. Only after electrical tests, communications checks, and utility requirements are satisfied does the installer walk you through shutdown procedures, manuals, and warranty details.

NABCEP's industry task analysis for certified storage installers allocates 30% of its exam content to installation and another 17% to commissioning, which tells you how much weight the industry places on getting these final steps right.
Post-Installation Checks and Validation
Once the battery is mounted and wired, validation determines whether it will actually work when you need it. Skipping this step can leave a system that looks finished but fails during an outage.
A thorough post-installation review covers:
- Inspect mounting, enclosure condition, conduit, cable protection, grounding, and signs of moisture or heat damage
- Confirm the battery charges from the intended source and communicates with its monitoring app
- Verify backup behavior: safe grid isolation, transfer to designated loads, and grid reconnection
- Match the final system against the approved design, inspection records, and warranty registration
Watch for warning signs that something went wrong during installation:
- Repeated fault codes or unexpected battery cycling
- Failure to enter backup mode when tested
- Overheating alerts or communication loss
- Nuisance breaker trips
- Unexplained drops in solar production
- Backup loads that exceed the system's actual capacity

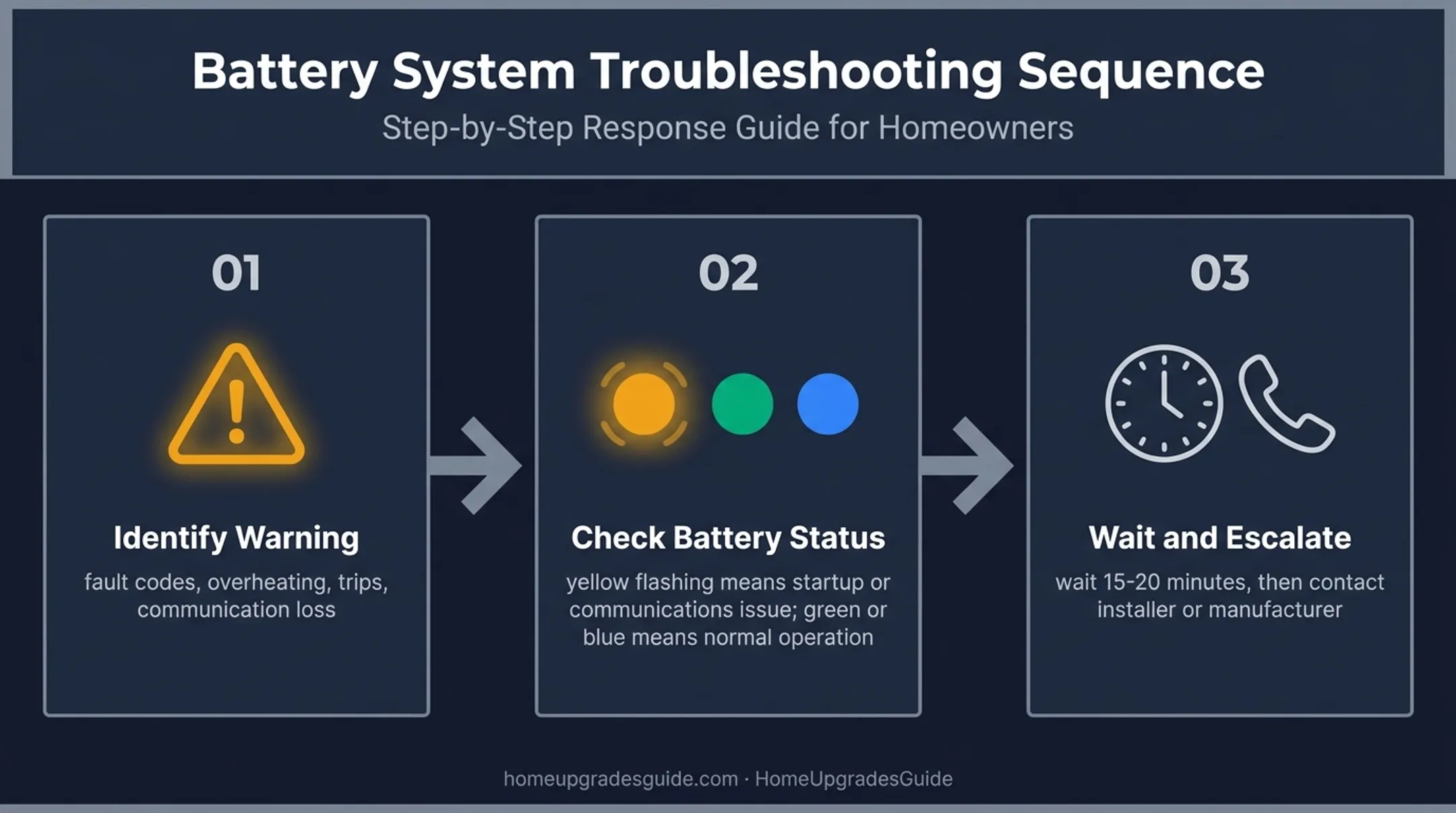

Enphase's owner's guide for the IQ Battery 5P describes a rapidly flashing yellow light as a start-up or communications issue, while solid or pulsing green and blue indicate normal operation.
If your app shows batteries not reporting, the manufacturer typically recommends waiting 15-20 minutes before assuming there's a real problem. Beyond that, don't attempt repairs yourself. Contact your installer or the manufacturer's support line.

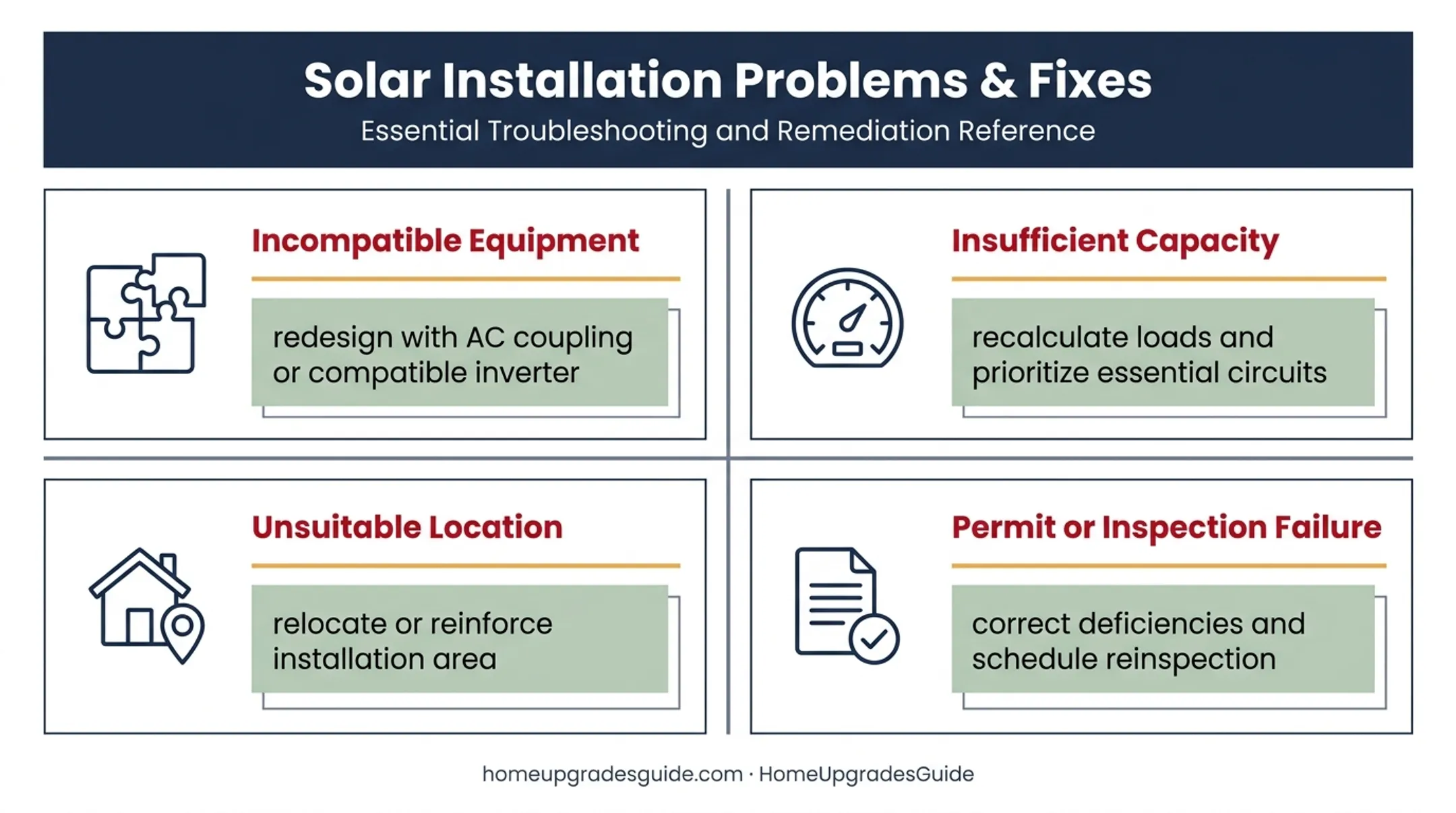

Common Installation Problems and Fixes
When something goes wrong, the fix belongs with your installer or the manufacturer, not with a homeowner opening equipment or bypassing a protective device. Here are the issues that come up most often.
Incompatible Existing Solar Equipment
Problem: Your existing inverter, battery, or monitoring platform can't support the new battery you want to add.
Likely cause: The retrofit design skipped verification of equipment models, firmware versions, or manufacturer-approved compatibility lists.
Fix: Redesign using AC-coupled equipment, a compatible hybrid inverter, or necessary equipment replacement, then update permits and utility paperwork accordingly.
Insufficient Electrical Capacity or Backup Design
Problem: The battery can't power intended appliances, or it trips during motor startup.
Likely cause: The original quote focused on kilowatt-hour capacity without properly evaluating continuous power, surge demand, or panel limits.
Fix: Recalculate loads, prioritize essential circuits, and add load-management equipment or a dedicated backup-loads panel.
Unsuitable Location, Clearance, or Environmental Conditions
Problem: The chosen spot fails clearance, temperature, or structural requirements.
Likely cause: The installer chose the site for convenience rather than code compliance.
Fix: Relocate or reinforce the installation area and get design approval before moving forward.
Permit, Inspection, or Commissioning Failure
Problem: The system can't legally be energized or fails inspection.
Likely cause: Missing documentation, incorrect labeling, or incomplete grounding.
Fix: Have your installer correct the deficiencies, schedule reinspection, and complete remaining utility steps.

Pro Tips for Installing Home Solar Batteries Effectively
Getting a battery installation right starts long before anyone shows up with tools. A few practical habits separate a smooth project from a costly headache.
- Define your priority first. Decide whether you need resilience, savings, or self-consumption before comparing equipment. This stops you from paying for capacity your household doesn't actually need.
- Price combined and future installs separately if you're planning solar and storage together. Ask contractors to break out the cost of a later retrofit, including permitting and crew mobilization.
- Compare quotes on real specs, not brand names. Usable capacity, continuous and peak power, warranty terms, and degradation coverage matter more than a headline capacity number.
- Ask about AC- versus DC-coupling and why your installer recommends one over the other given your existing solar setup and inverter age.
- Request an itemized proposal that separates battery equipment, labor, permits, panel work, and monitoring fees.
- Keep your documentation organized in one place: single-line diagrams, permit records, equipment manuals, warranty info, and installer contact details. You'll need them if something goes wrong years down the road.
Comparing more than one quote is worth the extra day it takes. EnergySage's 2026 marketplace data puts the average installed cost of a typical 13.5 kWh battery at $15,647 before incentives, though pricing swings widely by brand and project scope.
HomeUpgradesGuide helps homeowners request free project quotes from vetted local solar professionals, compare contractor matches, and decide who to contact and when, without needing to commit to a phone call right away.
Conclusion
Installation quality determines everything that follows: battery safety, backup reliability, energy performance, and whether your warranty actually holds up when you need it. There's no shortcut around that.
Start by defining your energy goals, then verify compatibility and site conditions before anyone signs a contract. Insist on properly permitted professional installation and full commissioning, because a battery that looks installed isn't the same as one that's ready to perform during a real outage.
The practical next step is straightforward: get itemized quotes from qualified solar-storage contractors and compare their proposed equipment, backup design, and support terms side by side.
Frequently Asked Questions
How much does it cost to install a solar battery?
Total installed cost depends on battery capacity, brand, labor, permitting, and new vs. retrofit work. EnergySage's 2026 data shows essential-loads backup from $5,000 to $18,000, and whole-home multi-battery setups from $24,000 to $40,000.
Can I add a battery to my existing solar system?
Many existing solar systems can accommodate storage, but it depends on your inverter, coupling method, and utility requirements. AC-coupled retrofits often avoid replacing your existing inverter, while DC-coupled setups may require one.
What size solar battery is needed to power a house?
Sizing depends on which appliances you back up, their starting and running power, and desired outage duration, not home square footage. A Berkeley Lab study found 15 kWh covered most homes for a 3-day outage, excluding heating and cooling.
Do I need a permit to install a home solar battery?
You'll typically need permits, inspections, and utility approval, though exact rules vary by state, local authority, and system design. Confirm requirements with your installer and local permitting office before work begins.
Can I install a solar battery myself?
No. Grid-connected battery installation involves high-voltage electrical work, fire-safety controls, and utility interconnection that require a licensed professional. Manufacturers like Enphase explicitly restrict installation to certified installers.
How long does home solar battery installation take?
Physical installation typically takes one day with a two-person crew, according to EnergySage. The full project timeline, including permitting and utility approval, can add days to several weeks depending on your location.
