Electrical Panel Upgrade and Solar Some homes can go solar without touching the electrical panel. Others need a full upgrade first. The difference comes down to five things: your panel's rating, its condition, available breaker space, the size of the solar system you're installing, and what your local utility and building department require.

Homeowners researching solar usually worry about the same handful of issues: surprise costs mid-project, permitting delays, electrical safety, and whether the panel will also handle a battery, EV charger, or heat pump down the road. Those concerns are valid. A panel upgrade can add thousands of dollars to a solar quote if it's sprung on you after the contract is signed.

This guide walks through how panels and solar interact, the specific triggers that call for an upgrade, the alternatives worth asking about, what an upgrade project actually involves, and how to compare proposals before you commit.

Key Takeaways

  • A 100-amp panel, breaker-space shortage, or aging equipment can limit solar options without forcing a full service upgrade.
  • Only a licensed electrician or solar pro can verify busbar rating, existing loads, and local code requirements.
  • Subpanels, right-sized inverters, and load-management devices can sometimes avoid a full upgrade.
  • Demand itemized proposals that separate equipment, labor, permits, and utility coordination costs.

How Your Electrical Panel Works With Solar

Your main electrical panel is the point where utility power enters your home and gets distributed to individual circuits through breakers. When you add solar, an inverter connects your rooftop generation to that same panel, effectively creating a second power source feeding into the busbar alongside the utility supply.

That's the part many homeowners miss. Solar isn't just "added on" to a panel. The panel has to safely manage power flowing in from the grid and power flowing in from your solar array at the same time. The number of rooftop panels you install matters far less than whether the electrical panel underneath can handle both sources without exceeding safe limits.

Terms You'll See in a Solar Proposal

  • Service rating or main breaker rating – typically 100, 150, or 200 amps, found on the panel's main breaker.
  • Busbar rating – the ampacity of the metal bars inside the panel that distribute current; this can differ from the main breaker rating and must be checked separately.
  • Breaker space – the physical slots available for new breakers, distinct from how many circuits you currently use.
  • Dedicated solar breaker – the breaker that connects the inverter output to the panel.
  • Subpanel – a secondary panel fed from the main one, sometimes used to solve space constraints.
  • Load calculation – the code-required math confirming your panel can handle existing and planned demand.

The 120% Rule, in Plain Terms

Most solar-on-existing-panel installations are evaluated using a busbar calculation commonly known as the 120% rule. In general terms: your main breaker rating plus 125% of the solar circuit's output current cannot exceed 120% of the busbar's ampacity. It's a busbar capacity check, not a rule about your overall service size.

IAEI's 2023 analysis walks through this exact formula with a worked example. For a panel with a 100-amp busbar and a 100-amp main breaker, the math allows roughly 16 amps of solar output. Scale that up, and a 150-amp busbar allows around 24 amps, while a 200-amp busbar allows around 32 amps.

Busbar & main breaker rating Approximate PV output allowed under the formula
100A ~16A
150A ~24A
200A ~32A

Solar busbar capacity chart showing allowable photovoltaic output by rating

These are illustrative numbers from a published example, not a substitute for a site-specific load calculation. Your electrician needs to verify the current code edition adopted in your jurisdiction, any local amendments, and the busbar label on your actual panel before relying on any figure.

One more distinction worth remembering: a panel that lacks physical breaker space is a different problem than a panel that lacks electrical capacity. The first might be solved with a subpanel. The second usually can't be.

When Does Solar Require an Electrical Panel Upgrade?

Several conditions commonly push a solar project toward a panel upgrade:

  • Lower-rated service, especially older 60-amp or 100-amp setups that weren't designed with modern household loads in mind.
  • Insufficient busbar rating for the proposed solar backfeed, even if the main breaker itself looks adequate.
  • No available breaker spaces, or unsafe conditions like double-tapped breakers where two wires share one terminal not rated for it.
  • Panel damage, including corrosion, overheating signs, or components under manufacturer recall.
  • Planned additions like battery storage, EV charging, or electric heating that stack demand on top of solar.

A 200-amp panel sounds like plenty of headroom, and often it is. But it's not an automatic pass. Busbar capacity, your home's existing loads, the inverter size you're proposing, panel condition, and local code can all still trigger upgrade work even at that higher rating.

Warning Signs Worth a Professional Look

If you notice any of these, flag it to an electrician before a solar install moves forward. Don't open or touch the panel yourself:

  • Frequent breaker trips with no obvious cause
  • Buzzing sounds or unusual heat near the panel
  • Flickering lights unrelated to appliance use
  • Rust, discoloration, or water staining on the panel
  • Missing knockout covers or exposed wiring
  • A panel that's already full, with zero open breaker spaces

A proper evaluation covers more than a glance. It typically checks:

  • Panel label and main breaker rating
  • Busbar condition and conductor/meter configuration
  • Available breaker spaces and existing circuits
  • Proposed solar equipment and any future electrical plans

That last point matters more than most homeowners expect. Adding a battery or EV charger can change the whole design, even when a solar-only system would have fit on the existing panel.

For example, a 100-amp panel might support a modest solar array alone. Add a Level 2 EV charger pulling 40 amps or more, and the load calculation can tip into upgrade territory.

Requirements here vary by state, city, utility, and even the specific equipment brand involved. Don't treat any single amperage number as a universal rule; what applies in one city's code adoption may not apply in the next town over.

When Can You Avoid a Full Panel Upgrade?

An upgrade isn't automatic. If your existing panel is in good condition, has adequate capacity and busbar headroom, and passes the required review for your proposed system, you may not need one.

A few alternatives a qualified professional might evaluate instead:

  1. Right-size the inverter. A smaller or differently configured solar system can sometimes fit within existing busbar limits without any panel changes.
  2. Use a different approved connection method. Supply-side connections attach ahead of the main disconnect rather than through the busbar, sidestepping the 120% calculation where your utility and local authority permit it.
  3. Add a subpanel. If the only issue is breaker space, not capacity, a subpanel or rearranged circuits can solve it.
  4. Install a listed load-management device. Enphase-style source-output controls limit solar output to busbar ampacity; devices like Lumin manage circuit-level loads instead. They solve different problems, so confirm which constraint your contractor is addressing.

None of these are DIY shortcuts. Each one has to be designed, installed, inspected, and documented by a licensed professional, and each carries trade-offs:

  • Right-sizing may mean less solar production than you originally wanted.
  • Alternative connection methods can add material and labor costs of their own.
  • Load-management devices add equipment cost and depend on compatibility with your specific inverter and panel.
  • Subpanels don't increase your home's overall service capacity, only its breaker space.

If a contractor recommends an upgrade, it's fair to ask whether they evaluated these alternatives first and why they ruled them out for your home specifically. The right answer depends on your panel, not on a generic sales script.

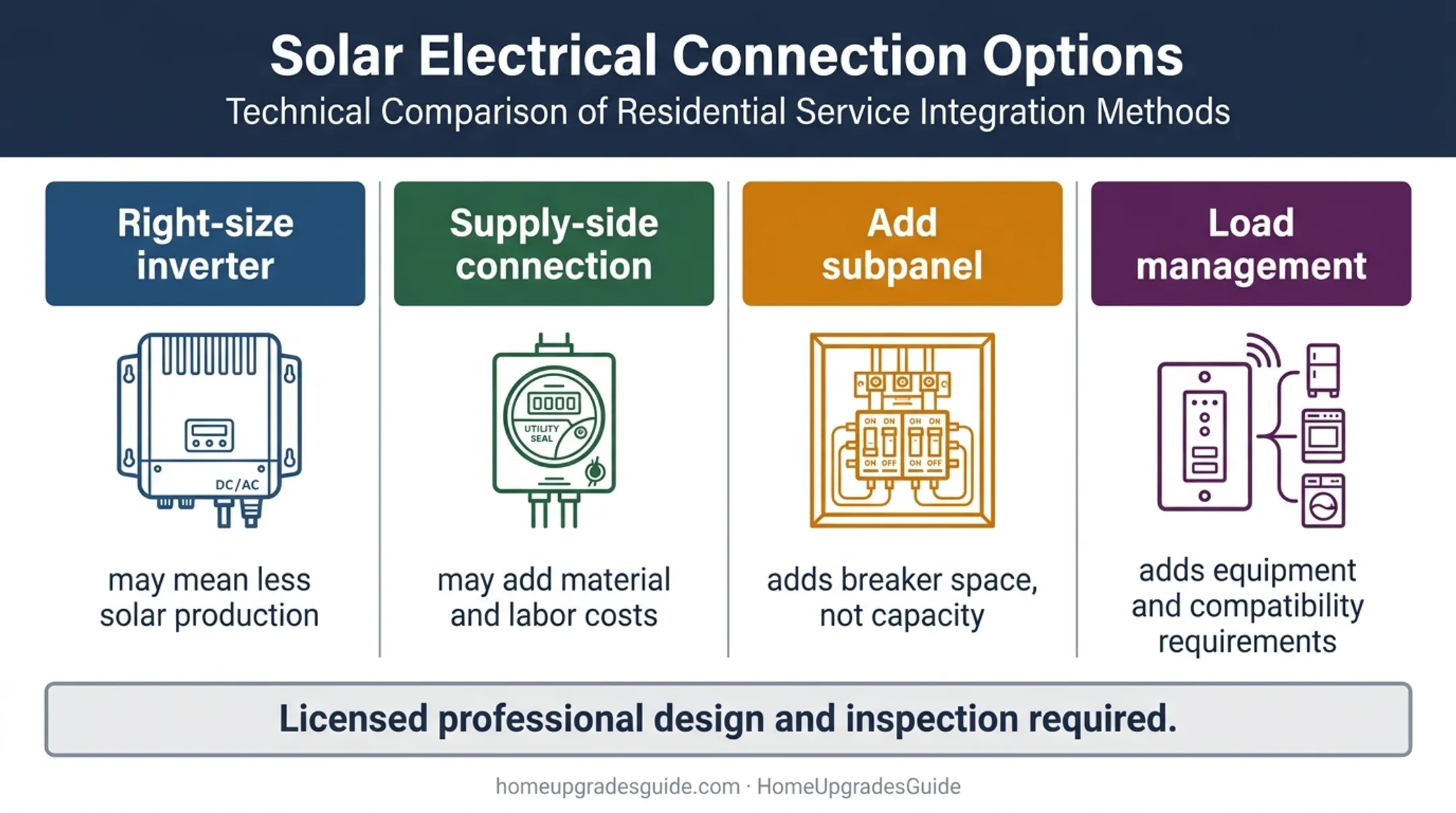

Four alternatives to full solar electrical panel upgrade comparison

Comparing more than one opinion helps here. HomeUpgradesGuide connects homeowners with vetted local solar contractors through address-based matching, so you can get multiple professional reads on whether your existing panel will work before assuming you need an expensive upgrade.

What Does an Electrical Panel Upgrade Involve?

When an upgrade is genuinely needed, the project typically follows this sequence:

  1. Site inspection and load calculation to document existing panel conditions and demand.
  2. System design and upgrade recommendation, specifying exactly what needs to change.
  3. Itemized quote confirming equipment compatibility with your proposed solar system.
  4. Permit applications and utility coordination, often running in parallel.
  5. Scheduled power shutoff while a licensed electrician performs the physical work.
  6. Inspection, utility approval, and solar commissioning, with documentation for your records.

It helps to know these terms aren't interchangeable, even though contractors sometimes use them loosely:

  • Panel enclosure or breaker replacement swaps components without changing service capacity.
  • Service capacity increase raises your home's overall amperage rating.
  • Meter socket or service conductor replacement addresses the wiring and metering equipment, separate from the panel itself.
  • Subpanel installation adds breaker space without touching the main service.
  • Full service upgrade typically bundles several of the above together.

What Drives the Cost

There's no honest universal price here, and anyone quoting a flat national number is guessing. Cost depends on:

  • Panel and service size being installed
  • Equipment location and wall access
  • Conductor, meter, or trenching work required
  • Grounding and bonding updates
  • Permit fees and utility requirements
  • Local labor rates
  • Whether solar, battery storage, or other work happens at the same time

Timelines vary just as much. Design, permitting, utility scheduling, inspections, and equipment availability all factor in, alongside the actual duration of your power interruption.

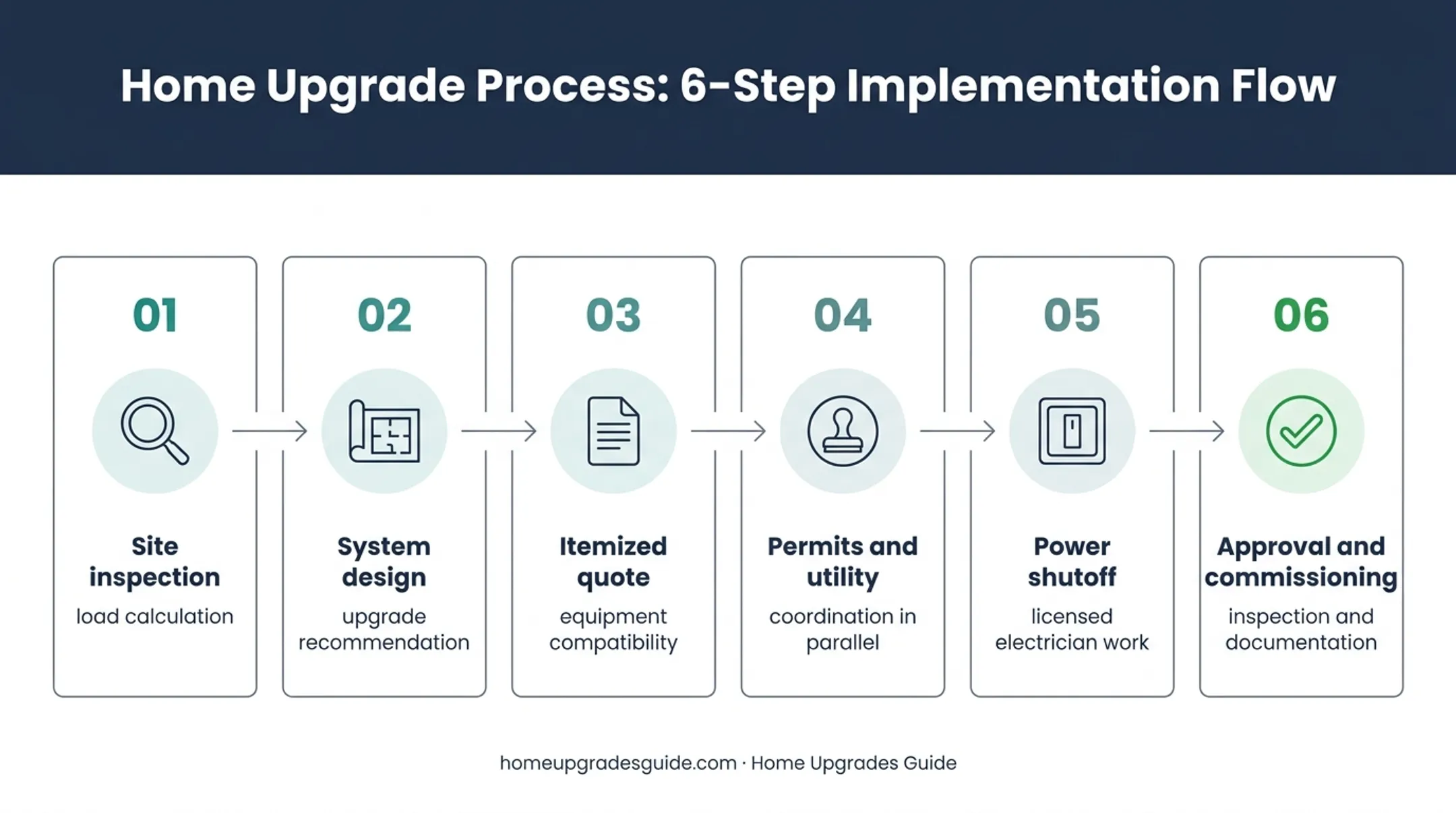

Six-step electrical panel upgrade process from inspection to commissioning

For context, NREL's 2022 report found utility pre-installation approval times for small residential systems ranged from a same-day median in some states to roughly 15 business days in others between 2017 and 2019. That figure covers utility approval only, not the construction and inspection timeline, so don't mistake it for a total project estimate.

Before signing anything, confirm your proposal includes:

  • All panel work, permits, and utility fees
  • Temporary power needs and disposal of old equipment
  • Inspections, warranties, and coverage for post-installation corrections

Main panel work should never be attempted by a homeowner, and solar installation shouldn't proceed until the electrical system has passed its required review.

How to Plan and Compare Your Solar Project

A little prep before your first contractor call saves real time later.

Before your consultation:

  • Photograph the closed panel label (don't remove covers)
  • Note the main breaker rating if it's visible from outside
  • List current and planned high-demand appliances, including any future EV charger or heat pump
  • Pull recent electricity usage from your utility bills
  • Note any existing solar, battery, or EV charging equipment

When comparing contractors, check for:

  • Relevant electrical and solar licensing plus insurance
  • Experience with load calculations, not just panel swaps
  • A clear permitting and utility coordination process
  • Equipment brands and warranty terms
  • Monitoring capabilities post-install
  • A documented change-order policy
  • Clarity on who, specifically, performs the panel work

When you're ready to gather quotes, HomeUpgradesGuide helps homeowners request free, no-obligation project quotes and compare vetted local contractor matches. The four-step process is simple: pick the project, share details, enter an address, and review matches.

You decide which professionals to contact and when. HomeUpgradesGuide doesn't perform electrical work or guarantee a specific quote.

Ask every contractor for an itemized proposal that separates solar equipment, panel or service work, batteries, optional upgrades, permitting, and any incentives or financing terms.

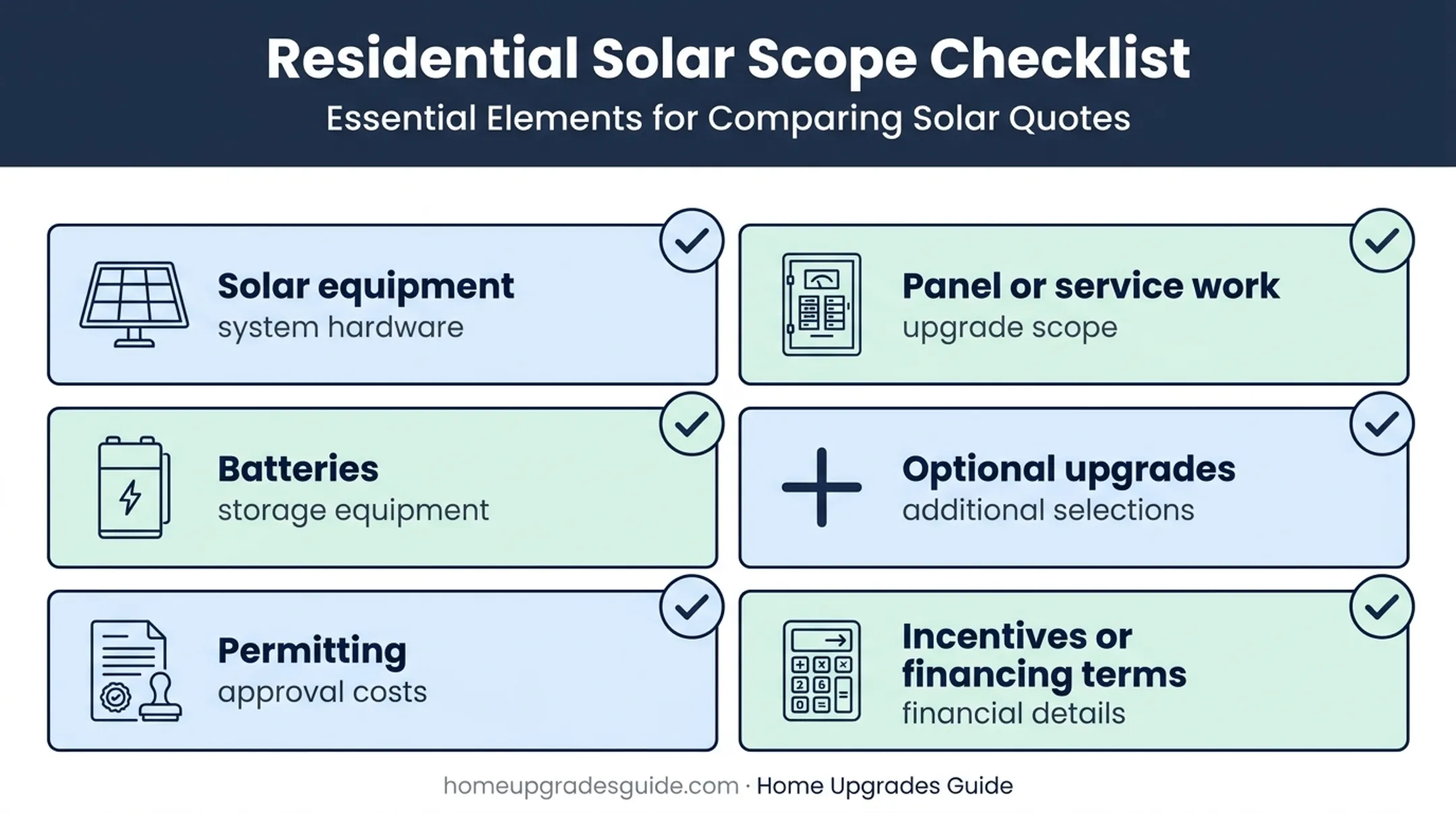

Itemized solar proposal checklist covering equipment permits and financing

If a proposal mentions tax credits or rebates tied to panel work, verify eligibility against current IRS guidance or a qualified tax professional rather than taking the contractor's word for it.

The practical rule: don't assume an upgrade is necessary, or unnecessary, until a qualified professional evaluates your actual panel against your actual solar design and local requirements.

Frequently Asked Questions

Can I get a federal tax credit for upgrading my electrical panel?

Eligibility depends on how the panel work integrates with a qualifying energy project and current IRS rules, which have changed recently. Check current IRS guidance and confirm specifics with a qualified tax professional before assuming any panel cost qualifies.

Do I need to upgrade my electrical panel for solar?

Some homes do, some don't. It depends on your service rating, busbar capacity, breaker space, panel condition, proposed system size, existing loads, and local approval requirements.

How much does an electrical panel upgrade for solar cost?

Pricing varies widely based on panel and service size, site access, utility requirements, permits, labor rates, and location. Get itemized local quotes rather than relying on a national average figure.

Can solar be installed on a 100-amp electrical panel?

Yes, in some cases. A smaller or specially designed system may fit within existing capacity, but this requires a load and interconnection review. A 100-amp service doesn't automatically qualify or disqualify a home.

How long does a panel upgrade take before solar installation?

Physical installation might take a day or two, but the full timeline includes design, permitting, utility coordination, and inspections, which can add weeks. Ask your contractor for a locally verified estimate.

Can I upgrade my electrical panel myself for solar?

No. Main-panel work carries shock, fire, and code-compliance risks that require a licensed electrician. Required inspections also won't pass without properly documented, professional work.
