How to Install Solar Panels on a Hillside Installing solar panels on a sloped lot isn't the same project as a flat-roof or flat-yard install. The slope changes how you build foundations, how water moves across the site, how crews reach the array safely, and how wiring gets routed without strain or damage.

Many homeowners underestimate this. A hillside array that looks straightforward from the driveway often hides soil variability, drainage complications, and access challenges that only show up once excavation starts.

This matters because the mistakes are expensive. Unstable racking, washed-out foundations, shading losses from poor row spacing, and failed electrical inspections all trace back to skipping proper site assessment. A qualified solar installer, a structural professional, and a licensed electrician each play a role here — this guide walks through the sequence from feasibility assessment to final commissioning so you know what to expect and what to verify at each stage.

Key Takeaways

  • Start with a topographic, shading, soil, and drainage assessment before ordering any equipment
  • Foundation choice depends on soil and slope: options range from driven posts to helical piles to ballast systems
  • Grading isn't automatic; compare its cost and runoff impact against contour-following racking
  • Permits, structural calculations, grounding, and final inspections are mandatory, not optional
  • Collect multiple site-specific proposals before picking a contractor

Installing Solar Panels on a Hillside: What the Process Involves

A hillside system moves through six broad phases. None of these can be skipped or reordered without creating problems downstream:

  1. Feasibility assessment
  2. Engineered design
  3. Permitting
  4. Foundation and racking installation
  5. Panel and electrical integration
  6. Final testing

Expect more coordination than a standard rooftop job. A sloped site typically needs:

  • A formal topographic survey (not just a visual walk-through)
  • Structural engineering stamped by a licensed professional
  • Civil input on drainage and erosion control
  • Specialized lifting or anchoring equipment depending on grade severity
  • Sign-off from solar, structural, and electrical professionals before the system goes live

Prerequisites and Safety Considerations

Before anyone breaks ground, the site needs a real evaluation, not a guess based on how the slope looks.

Site measurements to nail down:

  • Slope percentage and elevation changes across the array footprint
  • Orientation relative to true south and seasonal shade patterns
  • Property boundaries, required setbacks, and distance to structures or vegetation
  • Available space for panels, inverters, and service access

Soil and ground conditions:

  • Bearing capacity, rock presence, and groundwater depth
  • Erosion exposure, landslide risk, or wash/flood zone status
  • Whether foundations can be driven, drilled, or require alternative anchoring

Counties with active hillside oversight, such as Santa Cruz County, California, require engineering-geologic review when landslide history, groundwater, or post-wildfire debris-flow risk is present. If your site shows any of these signs, loop in a geotechnical engineer before finalizing a design.

Access and fall protection also need planning early. Under OSHA's fall protection rule, workers on an unprotected edge 6 feet or more above a lower level need guardrails, safety nets, or a personal fall-arrest system.

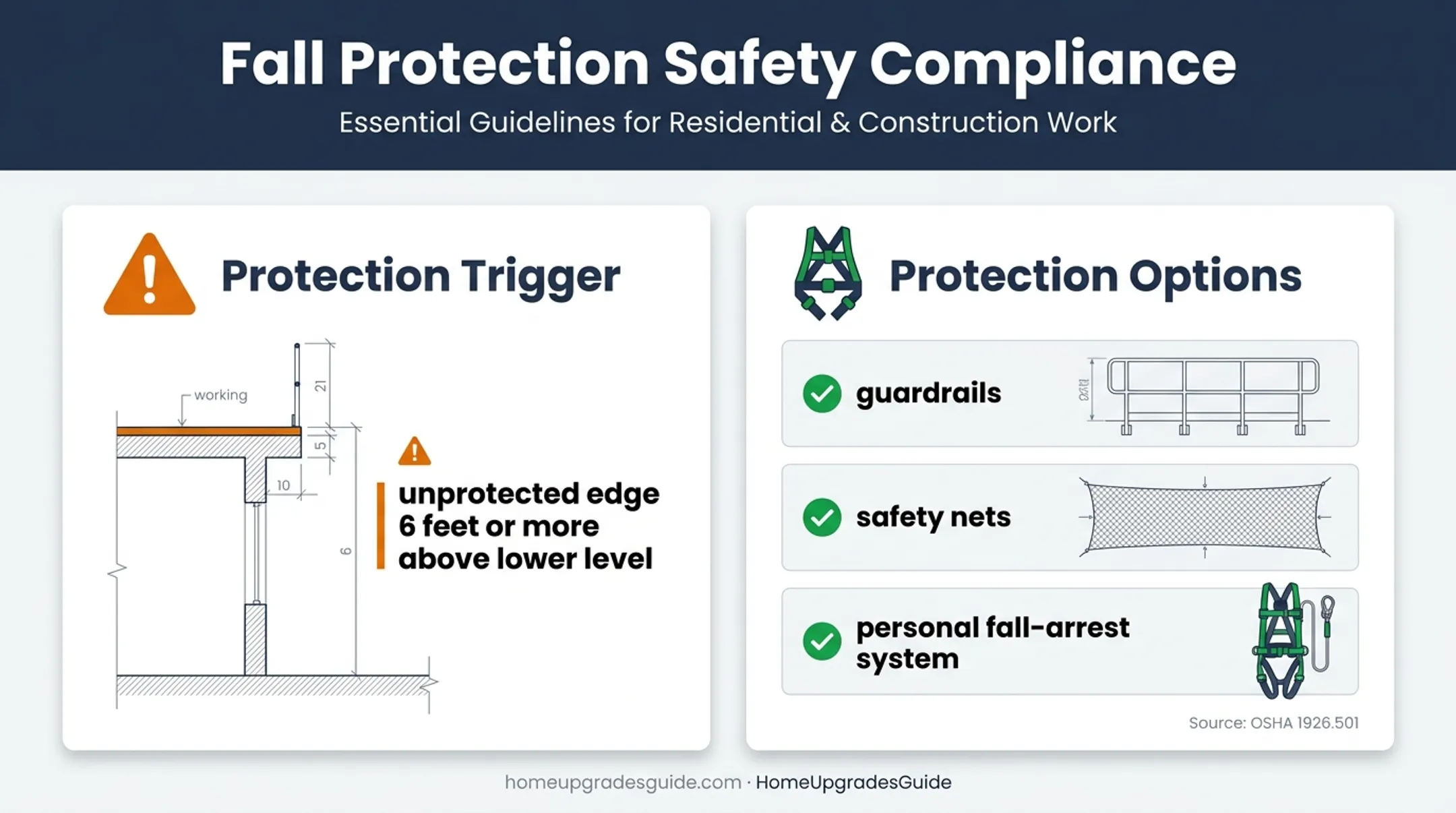

Hillside solar fall protection threshold and required safety systems

That threshold applies regardless of your hillside's overall grade, so any elevated work platform or trench edge meeting it triggers protection requirements.

Before construction begins, confirm local building, electrical, zoning, wildfire, and stormwater rules. These vary significantly by jurisdiction, so check with your local authority rather than assuming a national standard applies.

Don't proceed without redesign if:

  • Ground shows active erosion or landslide indicators
  • Access routes can't be made safe for crews and equipment
  • Drainage impacts remain unresolved
  • Setbacks or structural requirements can't be met as designed

Tools and Parts Required

The exact equipment list depends on your engineered design, soil type, and chosen mounting system, but most hillside projects draw from the same general categories.

Core components:

  • Solar modules, racking, posts, or foundation hardware
  • Clamps, rails, and support structures
  • Inverter, disconnects, conduit, and conductors
  • Grounding and bonding hardware
  • Monitoring equipment

Site-specific tools and machinery:

  • Surveying equipment (transit, string line, laser level)
  • Foundation-installation gear: post-hole diggers, powered augers, or pile-driving equipment
  • Lifting equipment for steep-grade material handling
  • Trenching tools and torque wrenches
  • Fall-protection systems

A key distinction matters here: manufacturer-approved components versus improvised substitutes. Racking, fasteners, and foundations must match the engineered design exactly. IronRidge's own installation guidance specifies precise torque values (for example, 15 ft-lb for top-cap U-bolts) because swapping in a "close enough" bolt or skipping torque verification can compromise the entire structure's load path.

How to Install Solar Panels on a Hillside (Step-by-Step)

Hillside installation follows an approved design sequence. Skipping steps or improvising in the field creates misaligned modules, uneven structural loads, and drainage problems that are far more expensive to fix than to prevent.

Step 1: Survey and Design the Hillside

An accurate topographic survey, combined with shade analysis, maps the slope's contours, array boundaries, row spacing, drainage paths, and equipment locations. This survey is the foundation everything else builds on, not optional paperwork.

Installers compare fixed-tilt, pole-mounted, adjustable, and tracking designs based on slope direction, maintenance access, and wind/snow loads. The decision between longer posts, smaller array sections, contour-following rows, or site grading usually comes down to:

  • How much earthwork grading would require
  • Whether contour-following rows meet production goals without flattening the land
  • Equipment access for ongoing maintenance

Step 2: Select and Engineer the Foundation and Racking

Foundation choice must match verified soil and rock conditions. IronRidge's installation manual identifies five foundation families — concrete piers, ground screws, helical piles, driven posts, and ballast — each requiring its own engineering validation rather than automatic substitution.

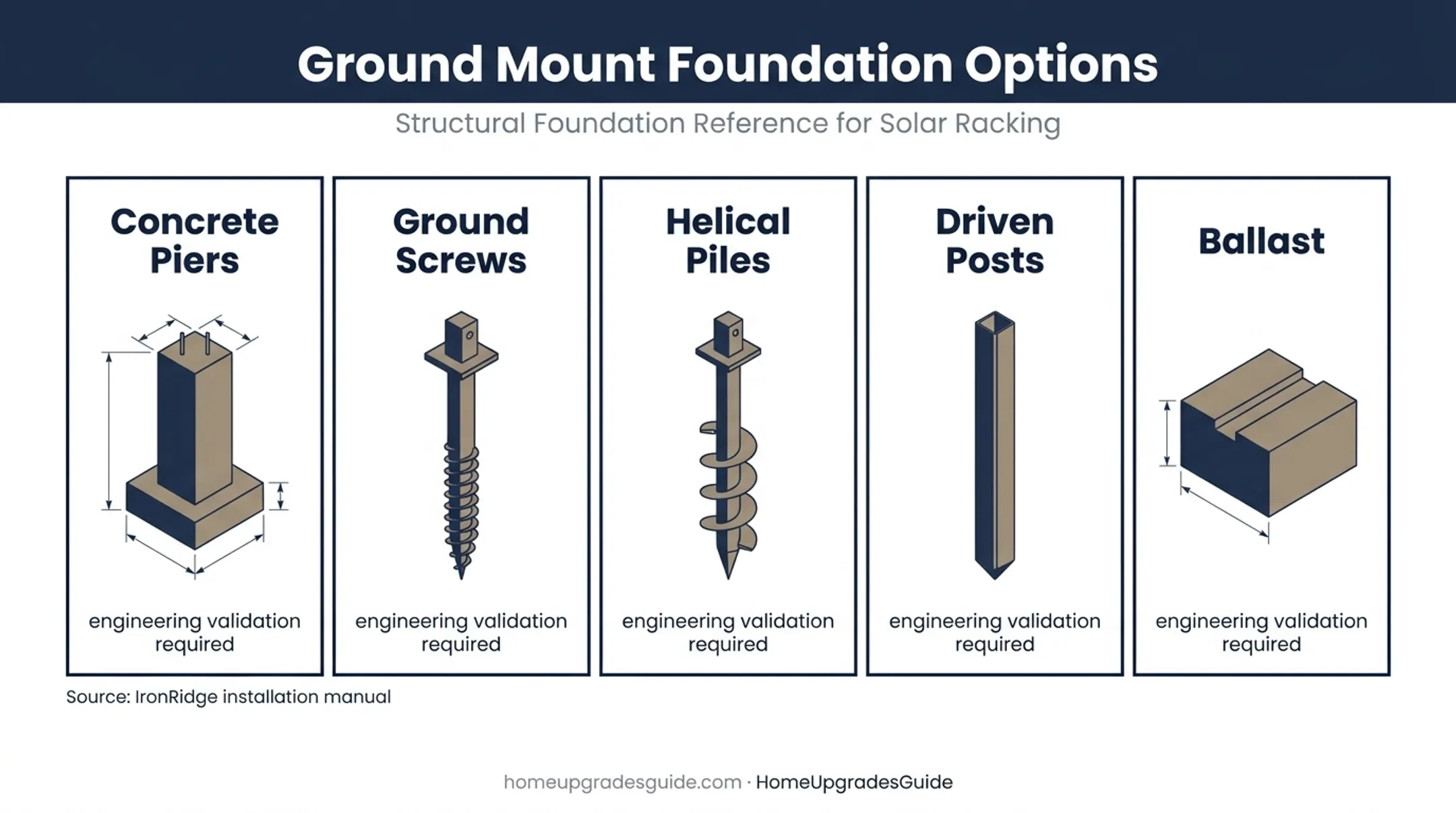

Five engineered foundation options for hillside solar panel systems

Posts generally stay structurally aligned even as the hillside's elevation shifts beneath them; the racking system is engineered to accommodate that variation within manufacturer tolerances. Structural calculations must account for:

  • Wind, snow, and seismic loads
  • Uplift and lateral forces
  • Soil strength and any retaining requirements

Grading versus adapting the mounting system is a real tradeoff. Grading changes runoff patterns and disturbs vegetation; adapting racking (longer posts, segmented rows) usually preserves the land but can add cost and complexity.

Step 3: Prepare the Site and Control Drainage

Work paths and staging areas should disturb as little soil and vegetation as possible. Steep access routes affect how materials get delivered and lifted, so this needs planning before trucks show up.

Erosion and stormwater controls go in before excavation starts — not after. The EPA's drainage guidance recommends minimizing steep-slope disturbance and using preserved vegetation, mulch, erosion-control mats, or velocity-dissipation devices where disturbance can't be avoided. Perimeter sediment controls belong downslope of any disturbed soil.

Trenching and conduit routes should follow natural contours while preventing water from using the trench itself as a channel.

Step 4: Install Foundations, Posts, and Racking

Foundations go in at the designed depth, spacing, and alignment, with inspection or photo documentation required before concealed work gets covered. Racking must transfer loads correctly without twisting, sagging, or creating uneven stress across modules.

If field conditions differ from the plans (rock where soil was expected, groundwater at a different depth), stop and get an approved design change. Don't improvise foundation depth, fasteners, or structural connections on the fly. Manufacturer instructions, torque verification, and corrosion protection all matter here, along with preserving required clearances around modules and wiring.

Step 5: Mount the Panels and Complete Electrical Integration

Modules go in according to the approved layout — clamp positions, row spacing, service clearances, all fixed in the design. Wiring and conduit need protection from abrasion, water, vegetation, snow, and mechanical damage.

Grounding, bonding, overcurrent protection, rapid shutdown where required, and labeling must follow the current National Electrical Code edition adopted in your jurisdiction. The final connection to your home's electrical system and the utility grid should be completed and verified by a licensed electrician. This isn't a DIY step regardless of how confident you feel with the rest of the project.

Post-Installation Checks and Validation

The system shouldn't go into normal operation until structural, electrical, drainage, and permitting items are all checked off.

Visual and mechanical inspection:

  • Level or approved contour alignment, loose hardware, damaged modules
  • Exposed conductors, unsupported conduit, sharp edges
  • Foundation movement or inadequate clearances

Documentation to verify:

  • Fastener torque records and foundation sign-off
  • Grounding and bonding continuity
  • Equipment labels and disconnect accessibility

System testing should follow inverter and manufacturer procedures. Confirm:

  • Startup behavior and monitoring communication
  • Voltage and current readings
  • Fault indicators
  • Rapid-shutdown function where applicable

Hillside-specific checks matter just as much:

  • Concentrated runoff or ponding near foundations
  • Exposed soil, sediment movement, or blocked drainage paths
  • Signs of undermining around posts or piers

Confirm all required building, electrical, fire, and utility inspections are complete. Keep permits, plans, warranties, and maintenance instructions on hand.

Skipped validation turns small alignment or drainage issues into structural damage, electrical faults, or warranty disputes later.

Common Installation Problems and Fixes

Issue 1: Uneven or Misaligned Panel Rows

Problem: Modules look twisted or inconsistently tilted across the terrain. Likely cause: The design didn't fully account for elevation change, or posts went in outside tolerance. Fix: Stop work, recheck the survey and engineering documents, and have the installer correct the support structure. Don't force panels into alignment manually.

Issue 2: Erosion, Runoff, or Water Pooling

Problem: Rainwater concentrates below panel edges or washes soil from around foundations. Likely cause: Altered drainage patterns, insufficient erosion controls, or poorly planned discharge points. Fix: Have a qualified professional redesign drainage and stabilize the area before continuing. Covering erosion with loose soil is a temporary patch, not a solution.

Issue 3: Difficult Access or Unsafe Working Conditions

Problem: Crews can't safely move panels or equipment; the slope gets slippery or unstable mid-construction. Likely cause: Inadequate staging, weather changes, or missing fall-protection planning. Fix: Suspend work, improve staging and access routes, bring in proper lifting and fall-protection equipment, and reschedule if weather or ground conditions make the site unsafe.

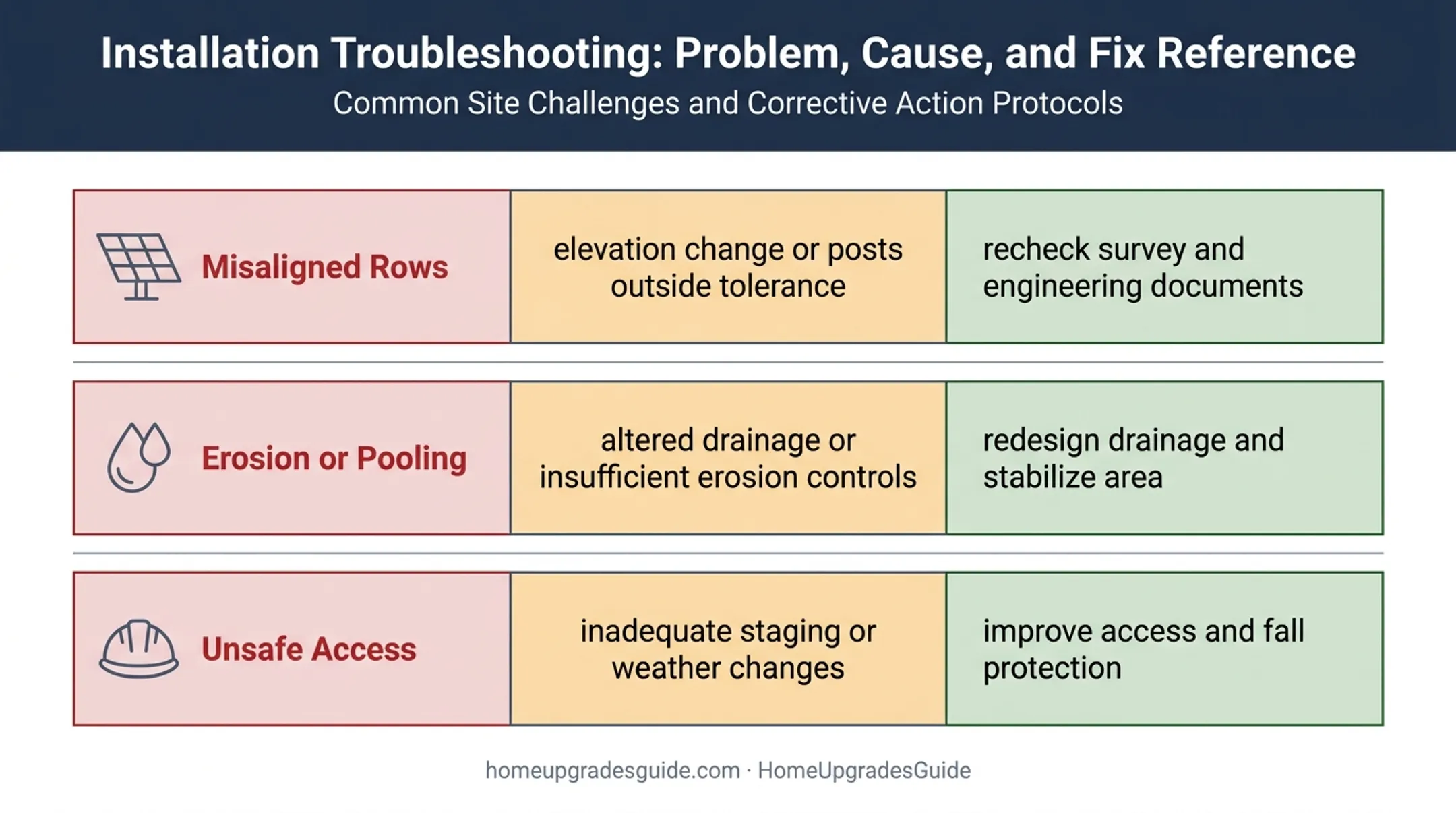

Three common hillside solar installation problems causes and fixes

Pro Tips for Installing Solar Panels on a Hillside

  • Sequence everything correctly. Survey, engineering, permitting, foundation work, electrical, and inspections need to happen in that order. Don't order equipment before the design is locked in.
  • Preserve natural drainage and vegetation wherever the design allows, and document pre-installation site conditions so any construction-caused changes are easy to identify.
  • Ask installers the right questions: how they handle topographic surveys, steep-site foundations, erosion control, structural calculations, and warranty support.
  • Get multiple written, site-specific proposals that separate out panels, racking, foundations, grading, trenching, electrical work, and inspections — not one lump-sum number.

This is where comparing options actually pays off. HomeUpgradesGuide's four-step process matches homeowners with vetted local solar contractors based on their actual address, and the request takes about two minutes. You review the matches and decide who to contact and when. No obligation, no cold calls until you're ready.

Hire a specialist immediately if you're dealing with any of these conditions:

  • Steep or unstable slopes
  • Exposed bedrock or retaining walls
  • Active erosion
  • Difficult utility routing
  • Wildfire or flood exposure
  • A tracking-system install

If the project exceeds your technical comfort level, call in help rather than push forward.

Conclusion

Hillside solar is feasible in plenty of situations, but installation quality directly determines energy output, structural stability, drainage behavior, and electrical safety for the life of the system. Rushing past site assessment or improvising foundation work is how expensive rework starts.

Begin with a professional site assessment, compare engineered installation options honestly, and don't proceed if ground or access conditions remain unresolved. When you're ready to compare options, HomeUpgradesGuide connects you with vetted local contractors through a free, no-obligation quote request. You can compare matches and choose based on fit and qualifications, not only price.

Frequently Asked Questions

Where should you not place solar panels?

Avoid locations with persistent shade, unstable or eroding ground, active drainage channels, flood or wash areas, unsafe access, or insufficient setbacks. Any site that can't support an engineered foundation needs redesign before installation. Check local rules and get a professional site assessment first.

What is the 36-inch solar rule?

A 36-inch clearance requirement can apply to electrical working space, roof access pathways, or specific local fire-access codes, but it's not a universal rule for ground-mount hillside projects. Verify the current requirement with your local building department and your installer.

Can solar panels be installed on a steep hillside?

Steep slopes can work with engineered foundations, adjustable or segmented racking, safe access planning, and proper drainage controls. There's no universal slope limit. Every steep site needs site-specific structural and geotechnical review before design finalizes.

Do solar panels need to face south on a hillside?

South-facing orientation often helps in the U.S., but slope direction, shading, row spacing, and structural cost all affect the best layout. A production analysis specific to your site beats relying on compass direction alone.

Is it safe to install hillside solar panels yourself?

Basic planning and research are fine for homeowners to handle. Structural work, elevated installation, trenching, and electrical connections need qualified professionals for design, foundations, wiring, utility interconnection, fall protection, and inspections.
